QuickStackQuickStack
How toNetworking

Network Policies

Control traffic flow between QuickStack applications and external services using pre-configured network policy templates.

Network policies control traffic flow between applications within a project and regulate access to external services. QuickStack implements these using Kubernetes NetworkPolicy resources (enforced by kube-router in k3s).

By default, all apps in a project can communicate with each other and with the internet.

Policy templates

QuickStack provides four pre-configured templates:

Allow All (default)

  • Ingress: Traffic from all project apps + internet (via domain)
  • Egress: All outbound traffic
  • Use case: Development, unrestricted apps

Internet Only

  • Ingress: Internet only — blocks intra-project traffic
  • Egress: Internet only — blocks intra-project communication
  • Use case: Apps that only use external APIs

Project Apps Only

  • Ingress: All intra-project traffic
  • Egress: Intra-project only — blocks internet access
  • Use case: Internal services, databases, backend APIs

Deny All

  • Ingress: Blocks all incoming traffic
  • Egress: Blocks all outbound traffic
  • Use case: Highly sensitive apps, database egress isolation

Configuring a network policy

  1. Open the app and go to the Advanced tab.
  2. Toggle Use Network Policy to enable.
  3. Select a policy template from the dropdown.
  4. Click Save, then Deploy.

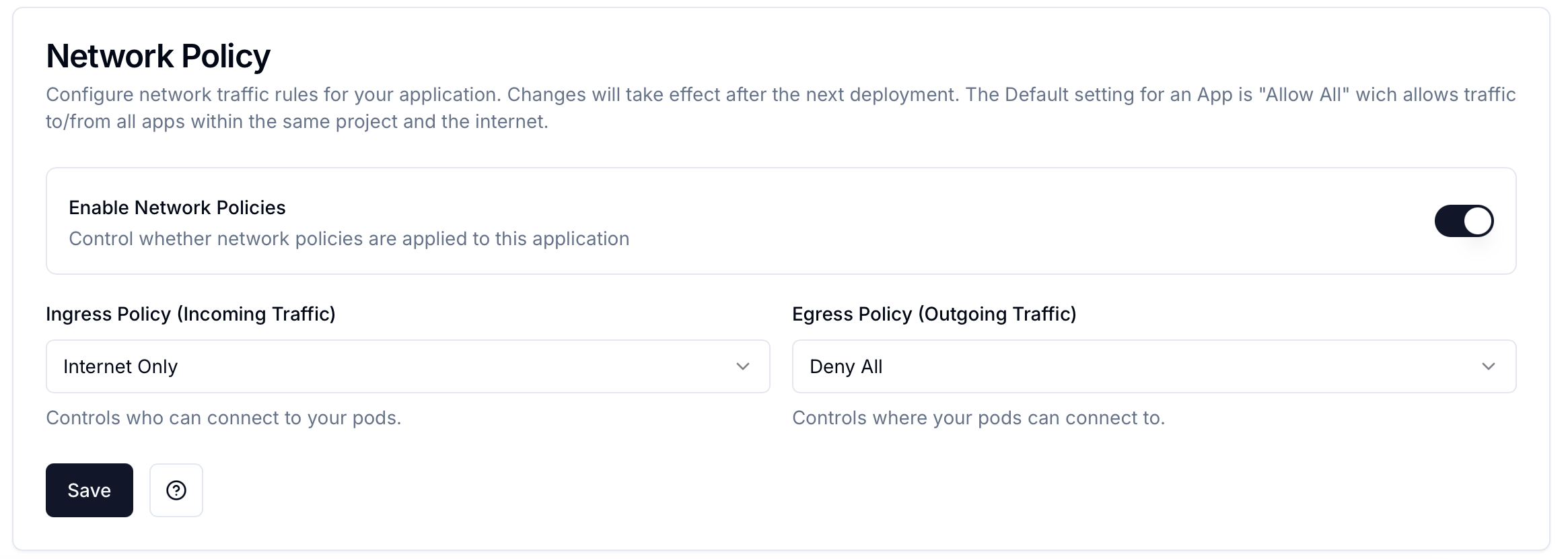

Network Policy Settings

warning Redeployment required Network policy changes require a redeployment. Existing connections may be terminated when policies are updated.

Network graph visualization

Open the project overview → Network Graph tab to see all apps and their network connections visually.

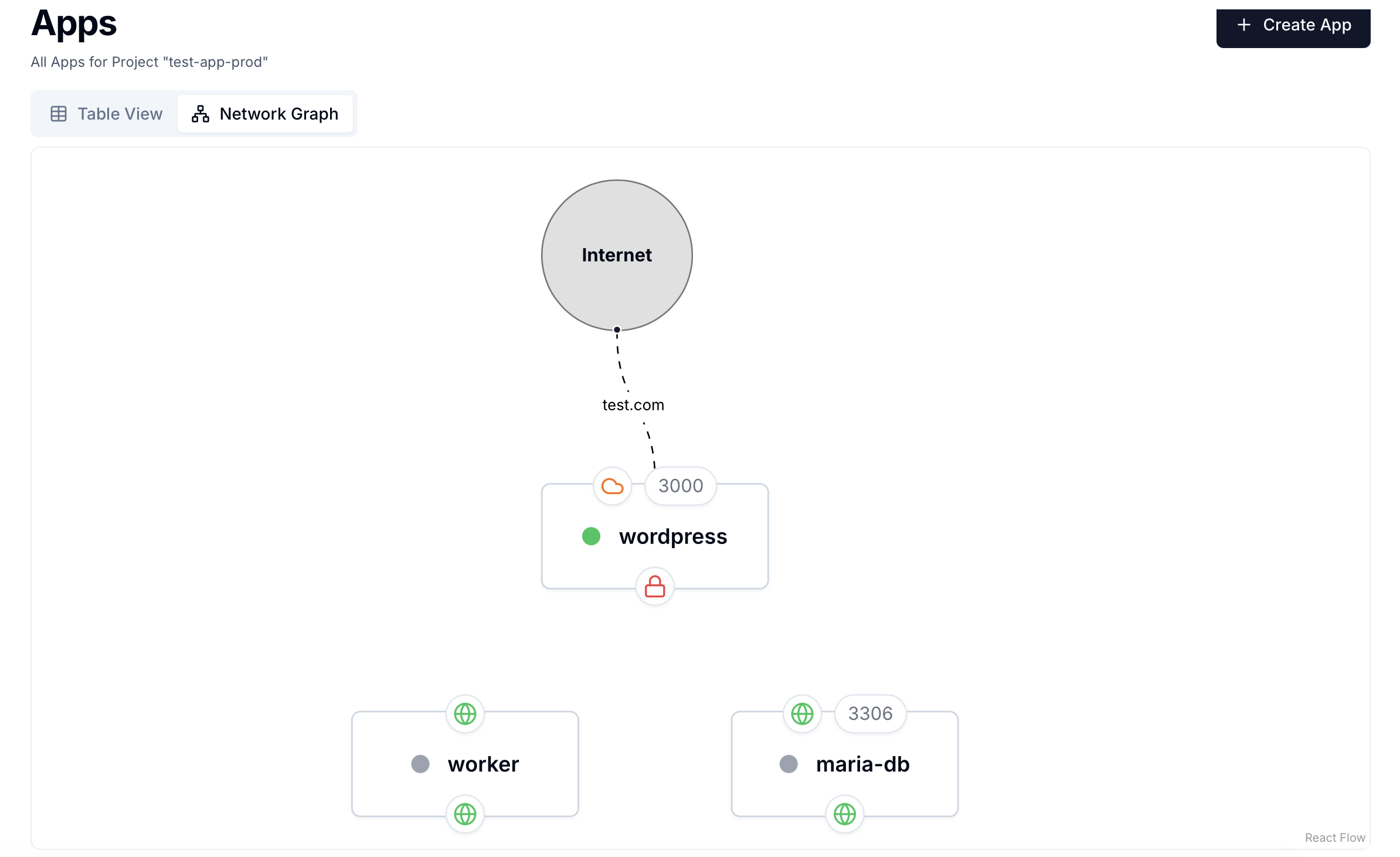

Project Network Graph

Troubleshooting

SymptomFix
App can't connect to databaseCheck if the database has "Deny All" or "Internet Only" policy; both block intra-project traffic
App can't reach internetCheck if "Project Apps Only" policy is set on that app
Policy not taking effectConfirm you redeployed after saving the policy change
